Timeline

February 2021


*Resident Meeting Kickoff

March 2021


*Advisory Teem Kickoff Meeting
*Subgroup Meetings
*Resident Meeting

April 2021


*Beaumont Teacher Meeting
*Ssb-Group Meetings
*Resident Meeting

May 2021


*Resident Meeting

June 2021


*Neighborhood Open House
*Resident Meeting

July 2021-January 2022


*Resident Meetings

Hear the residents express their wants and needs for their community in their own words.

September 2022


*Choice Neighborhood Grant Awarded

March 2023


*Partner Kickoff

April 2023


*Resident Meeting

August 2023


*Phase 1 Groundbreaking
*Phase 1 Infrastructure Begins

November 2023


*First Phase Relocation Begins
*People Plan Approved by HUD

February 2024


*First Phase Relocation Complete
*Phase 2 Demolition Approved by HUD

May 2024


*Neighborhood Meeting
*Phase 1 Housing Plan Approved by HUD

June 2024

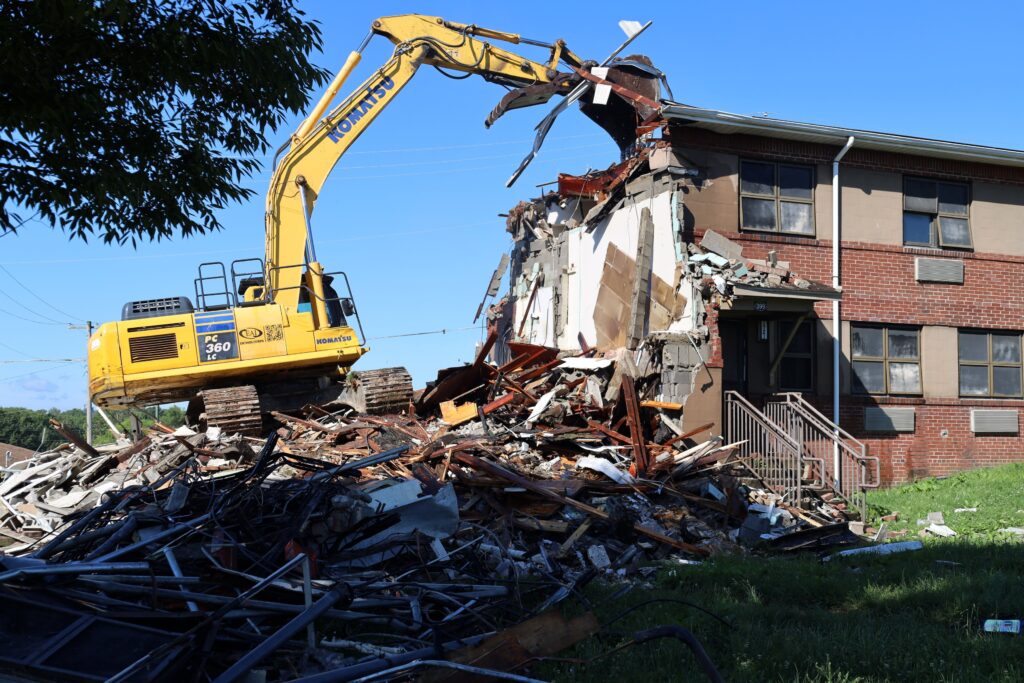

*First 12 Buildings Demolished

*Phase 1 Construction Begins

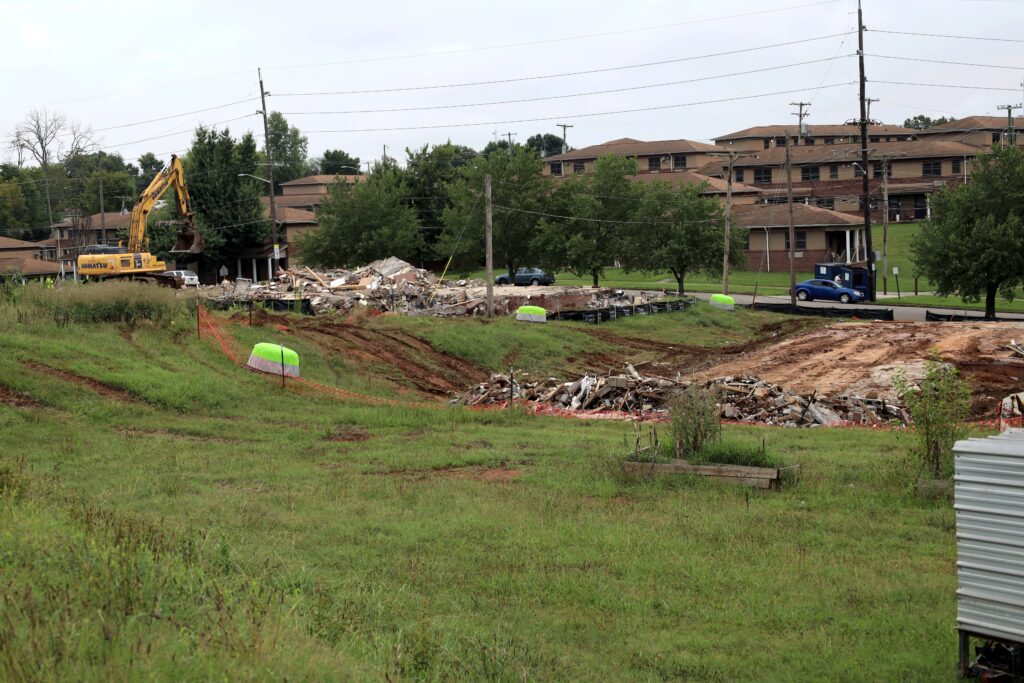

July 2024


*Phase 1 Infrastructure complete
*Phase 2/3 Infrastructure Work Begins

*Conceptual Neighborhood Plan is Approved

May 2025

default


* Phase 2 Housing and Town Center Construction Begins




December 2025

DJI_20260113140453_0537_D Residential area, Neighbourhood, Home, Asphalt, Urban design, Apartment, Suburb default

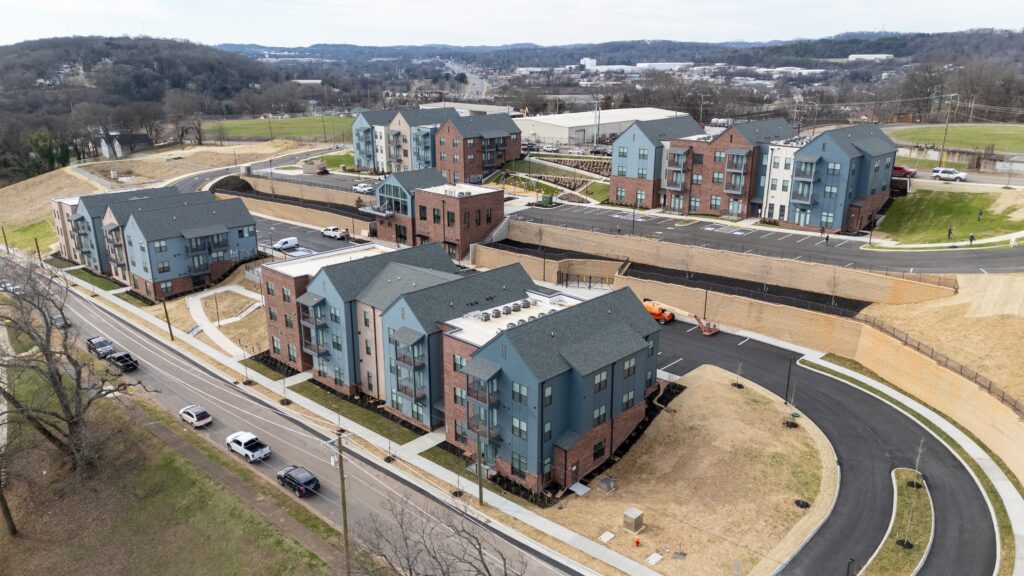

*Phase 1 Housing Complete

Phase 1 includes 76 total units

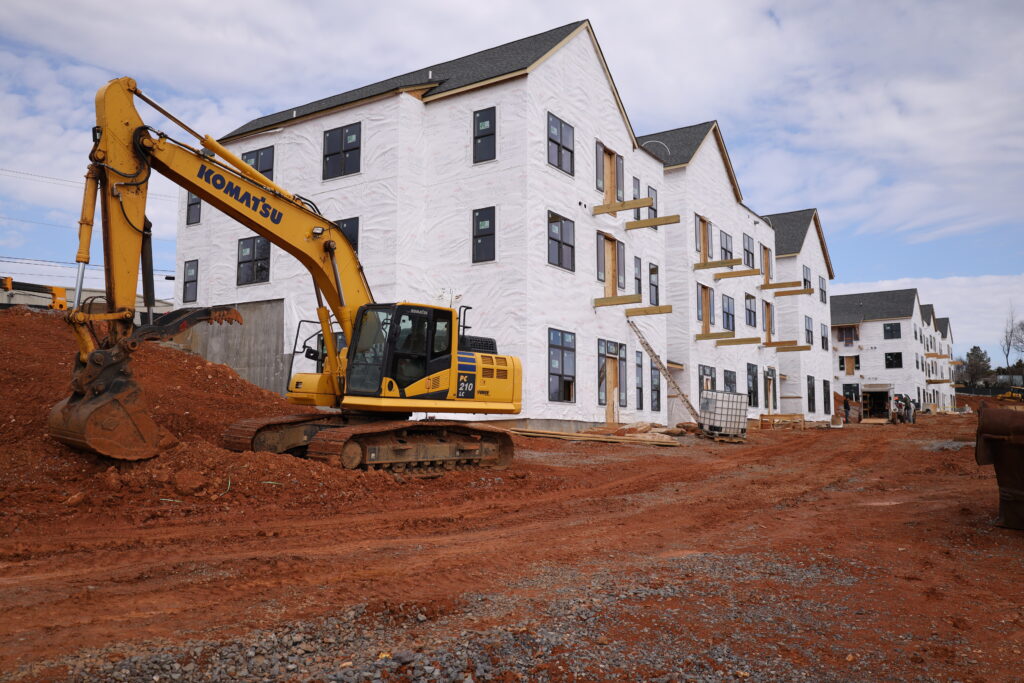

March 2026

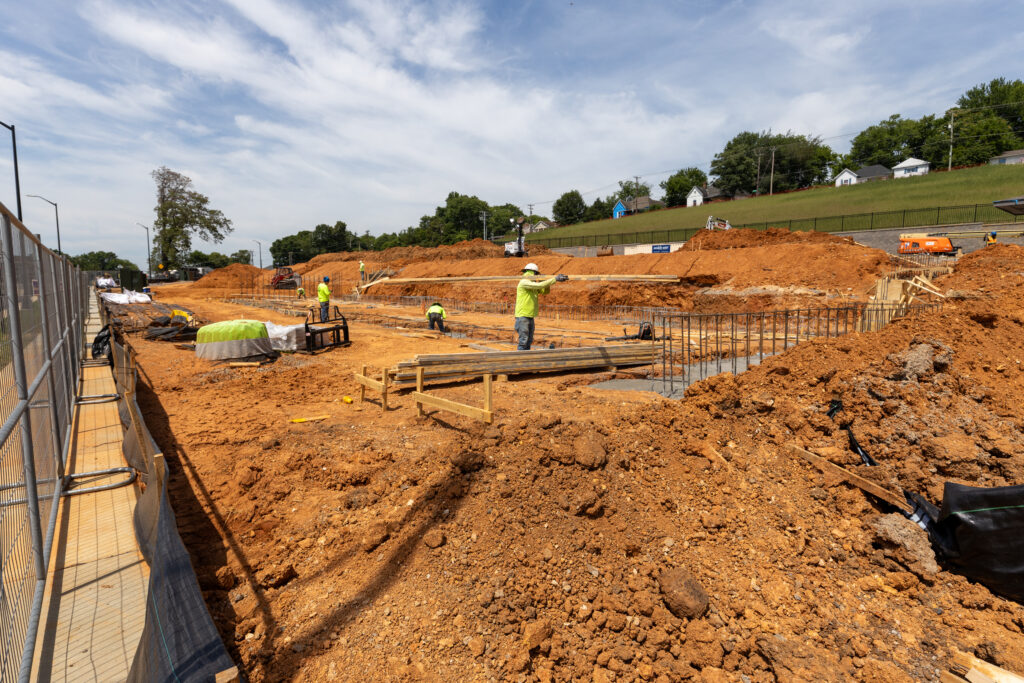

*Phase 4 Housing Construction Begins

July 2026

Remaining units demolished.

July 2026

Neighborhood Projects Begin

Connections Building featuring Real Good Kitchen and Junior Achievement

Destination Park and Splash Pad

July 2026

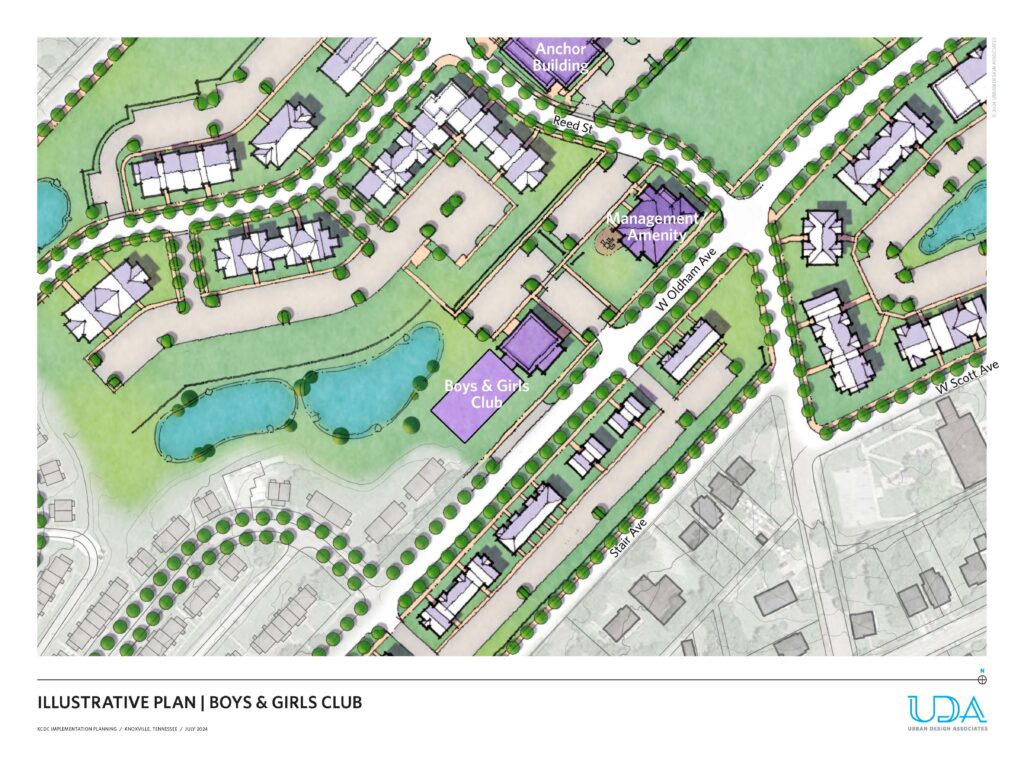

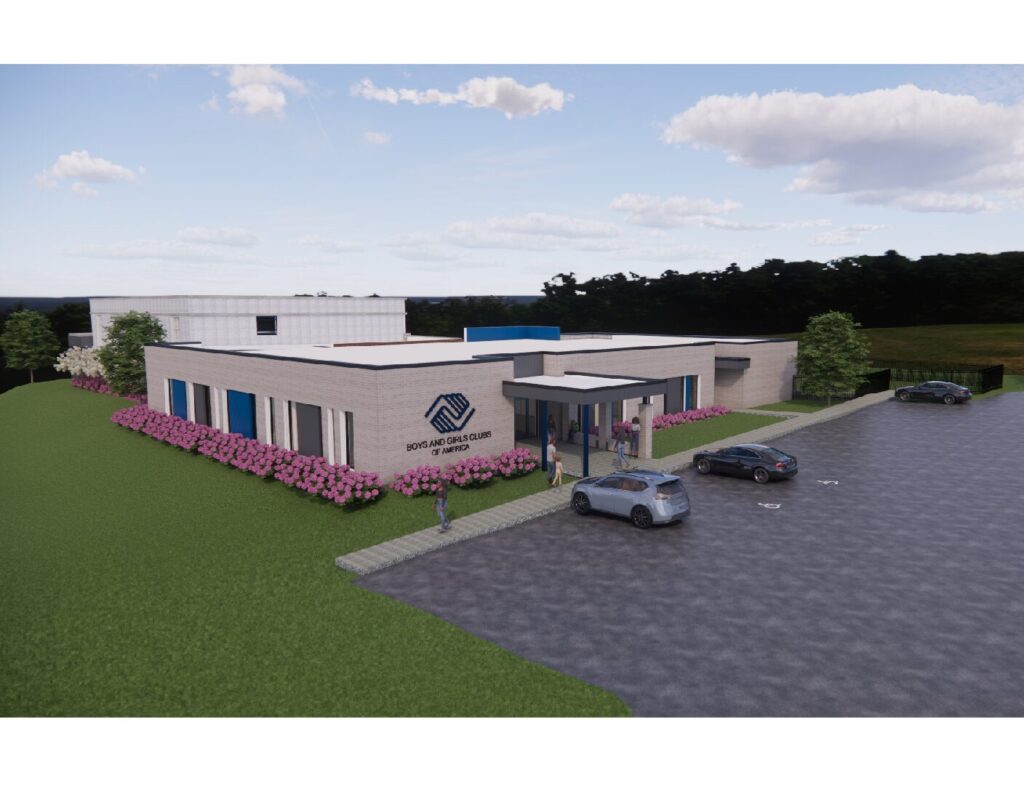

*Boys and Girls Club Expansion Begins

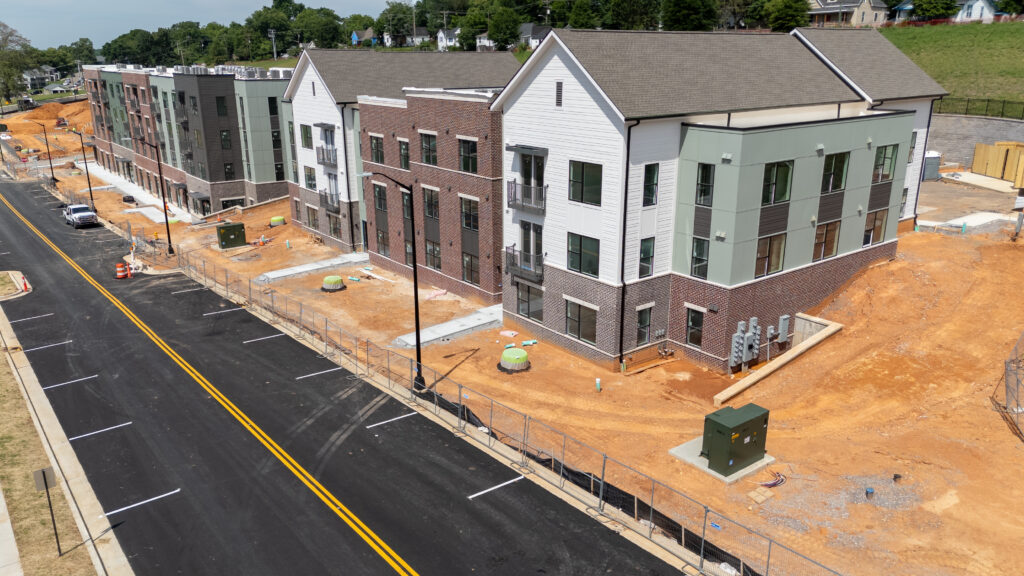

October 2026


*Phase 2 Housing Complete
*Town Center Complete

Phase 2 includes 52 total units

January 2027


*Phase 3 Housing Construction to Begin
*Boys and Girls Club Expansion to Begin (if funding complete)

June 2027

*Phase 4 Housing Construction Complete

Phase 4 includes 46 total units

December 2027

*Phase 5 Housing Construction to Begin

June 2028

*Phase 6 Housing Construction Begins

June 2028

*Phase 3 Housing Completion

Phase 3 includes 75 total units

August 2029

*Phase 5 Housing Construction Completion

Phase 5 includes168 total units

December 2029

*Phase 6 Housing Construction Completion
